Five speakers who agreed on little about the fine print agreed on the big thing: Alaska has to secure its energy future, and the window to decide how is closing fast.
ANCHORAGE (06/05/26) — Forum Summary by Ross Johnston, Executive Director
Watch the YouTube Below
For as long as Commonwealth North has existed, Alaska has been talking about a North Slope gas line.
Forty-seven years of discussion. A producer-led consortium, then a state-led corporation, now a developer-led model. The line has been studied, proposed, redesigned, and shelved enough times that Alaskans could be forgiven for treating the latest version as one more round of a familiar conversation.
It isn’t. And the forum’s five speakers, who diverged sharply on the fine print, were unanimous on the larger point: Alaska has to secure its energy future, and the easy decades of putting that off are over. Two things have changed since the last time this came up. The basin that has quietly heated Southcentral for two generations is running out. And for the first time, the project has a structure that could actually be financed. A perennial debate has become a decision with a clock on it.
Why This Time Is Different
The first reason is that the gas is genuinely running short, and John Sims, president of ENSTAR Natural Gas Company, made the case in numbers.

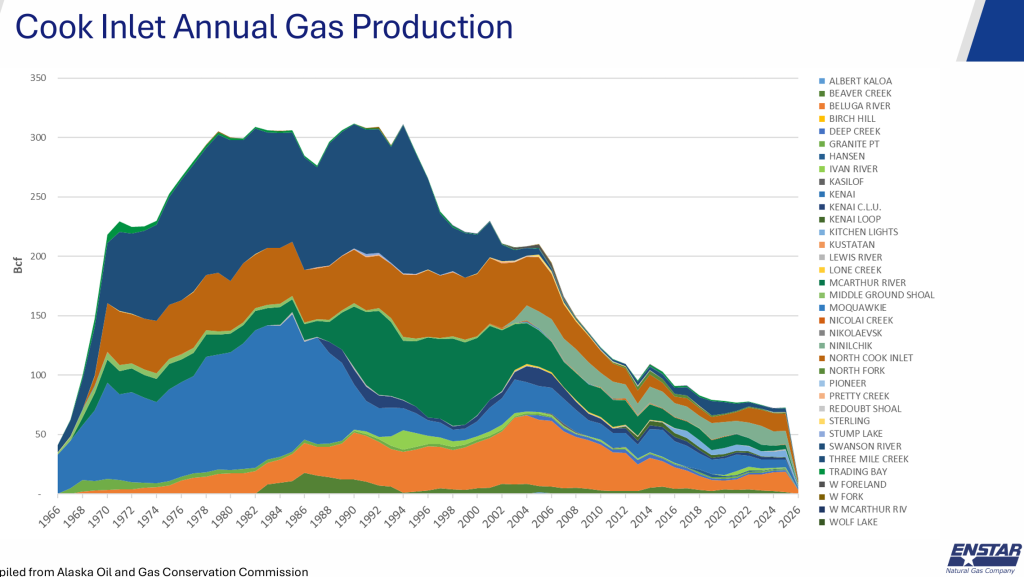

Cook Inlet produced more than 300 billion cubic feet a year at its early-1990s peak. Today it produces 60 to 70. On a severe cold-weather peak day, ENSTAR alone needs about 320 million cubic feet, more than the entire basin now produces on an average day.

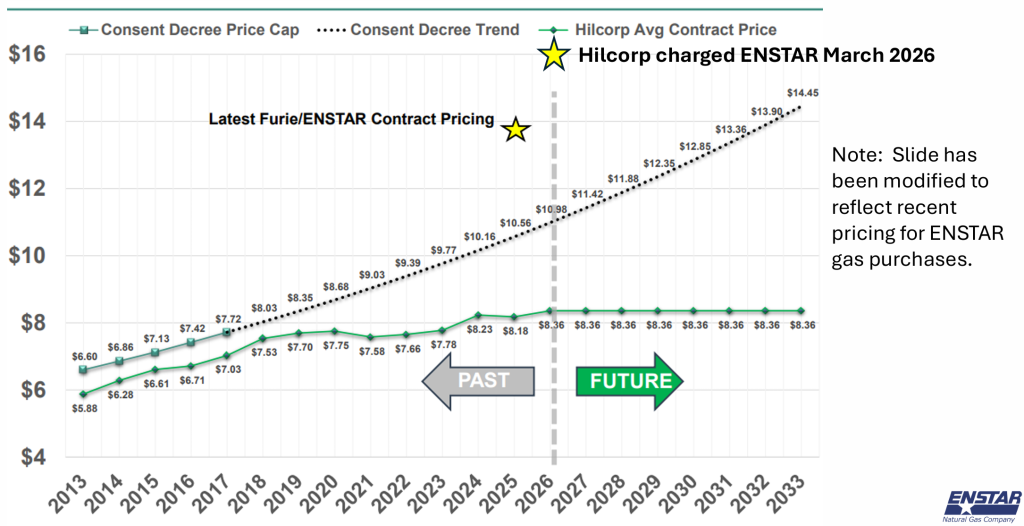

That 320 peak is also why storage matters so much. The basin cannot produce that volume on a cold morning, so stored gas, much of it held in the CINGSA facility, bridges the difference. Sims called storage one of the most valuable services Hilcorp provides, and a piece that every replacement option, import or pipeline, will have to expand.

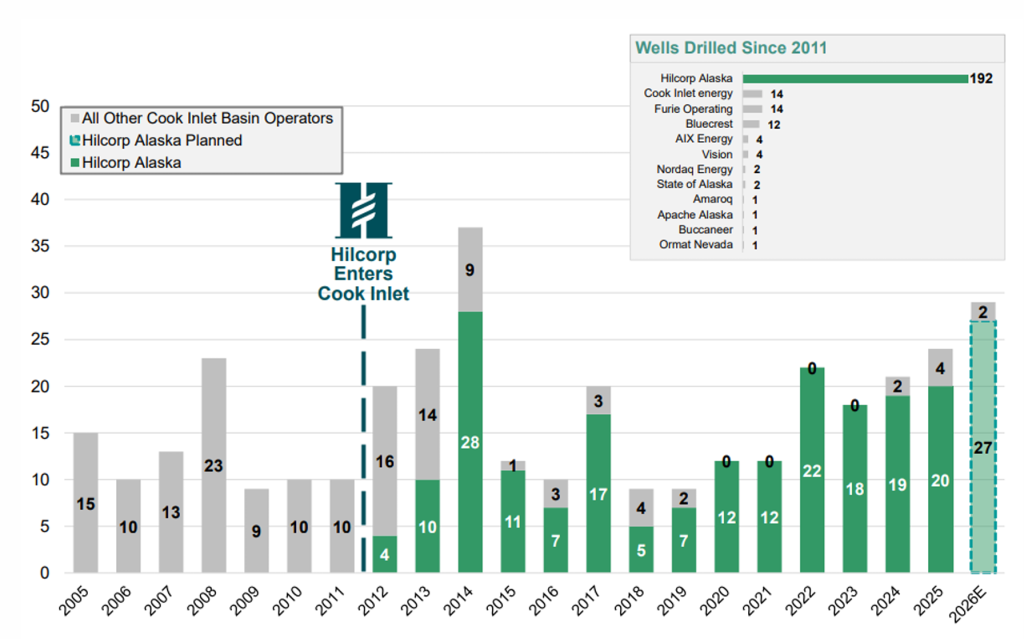

The basin has been carried, for more than a decade, by a single company. A 2010 study had warned that meeting demand would take up to 185 wells and as much as $2.8 billion. Hilcorp entered in 2012, drilled 192 wells, spent well over $1.5 billion, and kept the system whole. That is the good news and the exposure in one sentence. Almost all the recent drilling has been Hilcorp’s, and no one else carries a balance sheet to match it. The second-largest producer, HEX, made news last year by doubling output, from 10 million cubic feet a day to 25. Against a 320 peak, that is a rounding error. Prices are already moving: a cold March left ENSTAR short, and Hilcorp filled the gap at $16, against a base contract price near $8.36. In 2033, that Hilcorp contract ends. Every other number in the forum is downstream of that date.
The second reason is that the project finally has a shape that lenders might accept, and Matt Kissinger, commercial director at AGDC, walked through how it got there. The producer-led version collapsed because, by a 2016 Wood Mackenzie analysis, it was financed wrong, leaning on sponsor debt instead of project finance. The state-led version that followed never won the market’s confidence. The 2019 pivot to a developer-led model brought stage-gate discipline and the financing structure the 2016 report had recommended. Federal loan guarantees, amended to cover this project and now worth roughly $30 billion, lower the cost of debt.
Kissinger also made a point that often gets lost under the cost concerns: on the fundamentals, this is a strong site. Alaska’s land rights were resolved decades ago through the Native Claims Settlement Act, while LNG Canada’s were not, which fed that project’s delays and overruns. The route avoids the coastal mountains that were the hardest part of building the Trans-Alaska Pipeline. And the Nikiski terminal site is proven ground, next to a Kenai LNG plant that shipped to Japan for roughly 50 years without a missed cargo. What remains, Kissinger said, is the part still in the Legislature’s hands: a property tax that a benchmarking study found roughly ten times higher than competing jurisdictions. His comparison was LNG Canada, which pays about $27 million a year; even with the relief on the table, he said, Alaska’s project would still pay around five times that.
A deadline and a structure. Neither has been true at the same time before.
Four Futures, and Why Even Half Counts
Brett Watson, an economist at the University of Alaska’s Institute of Social and Economic Research (ISER), gave the afternoon its cleanest framework. He asked the audience to weigh four futures.

A successful project, finished on reasonable schedule and budget. A partial success, the Phase 1 pipeline without the Phase 2 export terminal. No project at all. And limbo, in which Alaska limps along on costly stopgaps while Phase 1 stays perpetually around the corner, deterring the very investment in alternatives a community would otherwise make. Limbo, Watson argued, is the worst of the four.
The prices are the spine of the whole thing. Walk the ladder.

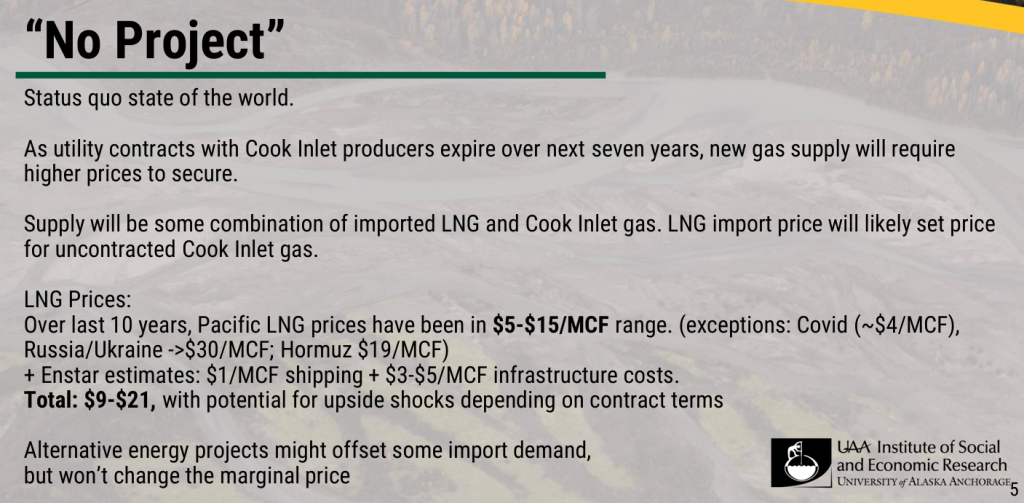

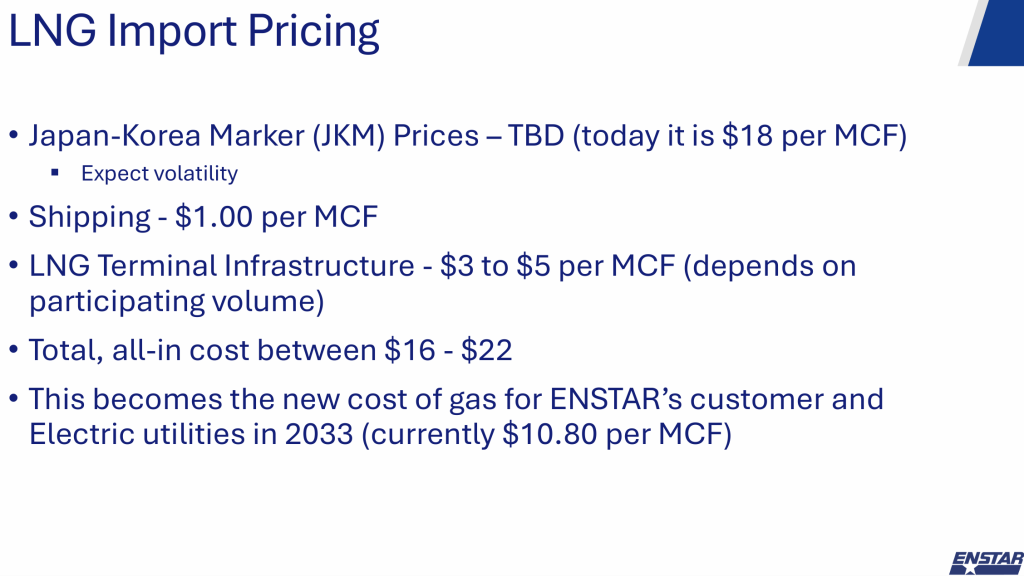

Today, gas runs about $10.80 per thousand cubic feet, by ENSTAR’s reckoning. In a no-project world, Alaska buys on the global market. Watson put the all-in landed cost of imported LNG at $9 to $21 in normal times; ENSTAR’s own figures, narrower and higher, land at $16 to $22, and the company expects that to become its customers’ baseline cost in 2033. Either way the number is volatile and exposed, with far higher spikes possible. Prices hit the high $30s after Russia’s invasion of Ukraine and sit near $19 today amid the closure of the Strait of Hormuz. Build Phase 1, and the price fixes at $16, escalating only slowly.
Build Phase 2, and it falls to $5.
That $5 is the prize, and it is the only number on the ladder that bends down instead of up.

Two things about that ladder deserve more attention than they got. The first is that a partial success is not a failure. Watson showed Phase 1 tracking the $16 line for the project’s first couple of decades, inside the band Alaska would have paid for imports anyway. Sims sharpened it in the Q&A: the Phase 1 price is fixed and capped, with cost overruns barred from reaching ratepayers, knowable out to year 25. The difference between no project and Phase 1, he said, is the difference between riding the world market’s volatility and locking in a price you can plan around. Phase 1 alone still beats the status quo.
The second is that the gap between Phase 1 and the full project is exactly what worries the people on the ground. Peter Micciche, mayor of the Kenai Peninsula Borough, asked the developers to wrap up Phase 2 alongside Phase 1. The “divorce” of the two phases, he said, has made his community and the rest of the rail belt nervous, because the cheap gas, the $5, only arrives if the second half gets built.
More Than a Price
The forum spent most of its oxygen on cost, but Watson was careful to note that a gas line is not only a price. The construction phase would bring thousands of jobs, with hundreds more in long-term operations and maintenance. Cheaper energy could pull back industrial demand the state has lost or never had: a restart of the Nikiski fertilizer plant, new mining such as the Donlin project, and the kind of data-center investment that follows low-cost power. His slides put state and local revenue at the full project stage at roughly $700 million to $1.4 billion a year, depending on the tax structure. There are strategic dimensions too, including energy security for the military bases that anchor a meaningful share of the state’s economy.
Micciche echoed the industrial piece from the borough’s vantage. The peripheral value, he said, is real but conditional: the shuttered fertilizer plant, the old Kenai LNG facility, and the Marathon refinery all become more viable if the delivered gas price lands low enough. None of it is guaranteed, and he was honest that modern facilities employ fewer people than the ones they replace.
Then Watson flagged the tradeoff that almost no one expects. The rail belt’s gain does not stay on the rail belt. Through Power Cost Equalization, the state program that helps rural Alaska afford electricity, rural and urban energy prices are linked. If cheaper North Slope gas pulls rail belt prices down, the gap that program is designed to close grows wider, and the state’s subsidy bill to rural Alaska could rise rather than fall. A win for urban ratepayers, in other words, carries a cost the whole state would share. It is the kind of second-order effect that rarely makes the slide deck, and it sat squarely inside Giessel’s later argument that every community should see something from a resource the whole state owns.
Keeping the Base Covered
The forum’s central tension was fiscal, and it is narrower than the headlines suggest. The two officials with the most to lose if the terms go wrong are not trying to stop the project. They are trying to make sure it does not bill the public for its own construction. Both, notably, want it built.
Micciche spoke for the place where the terminal would sit. The published construction estimates he cited put the LNG facility alone at $23.6 to $28.4 billion, and the borough’s projected impact runs about $30 million a year. At a residential neighbor’s rate, the facility would owe $212 to $255 million; under the proposed 75 percent reduction, it would pay a first-year effective rate near 2 mills, against the 9 mills a neighbor pays and the 20-mill statutory oil-and-gas rate. The borough will give up between $132 and $175 million and call it fair. What it will not do is go below break-even. “Struggling seniors in my community must get their costs covered,” he said. Then the part that matters as much as the floor: keep us whole, he told the panel, and the borough will be the same reliable partner it has been since 1969.
That is concession, not opposition. Cathy Giessel, the Senate Majority Leader and Senate Resources Committee chair, took the same posture at state scale. “I think we can do both,” she said of reasonable public revenue and a financeable project. “I support this gas pipeline, but we’ve got to do it wisely.” Her standard is constitutional, not personal. Article 8 of the Alaska Constitution obligates the Legislature to manage the state’s resources for the maximum benefit of its people, and she reads that as a duty to make sure Alaskans, not only the developer, see a return on gas the public owns.
The ceiling on how much the public can ask is set by the project’s own thin margins. Kissinger was candid that this is a marginal project, evidenced by the plain fact that it has not been built despite the need. A project like this, he said, cannot put out $800 million to a billion dollars a year in taxes. Those are not oil-project margins. The lever the Legislature holds is the property tax itself: the governor’s bill, introduced March 20, offers full relief for ten years of operations or until production reaches 1.0 BCF per day, then a small volumetric tax, scored by the Department of Revenue at about $74 million a year, a 90 percent cut. A higher rate, 12 cents per Mcf, surfaced in discussion.
The floor and the ceiling, in other words, are closer to a deal than to a standoff.
How You Tax, Not Just How Much
Watson’s deck carried a section the clock did not allow him to present, and it speaks directly to the choice in front of the Legislature: not how much to tax, but in what form.
The right tax level, in theory, is the one that maximizes the project’s net present value to the state. Set it too high and the economics weaken until the project is no longer viable.
One principle cuts against intuition. The state, Watson noted, is generally more patient than a private developer, which discounts future dollars more steeply. So a structure that collects less up front and more later can suit the state even when a developer would resist it. Profits-based taxes, for all their volatility, tend to distort investment the least, because they aim to skim the surplus rather than tax the activity that produces it.
The Work Still Being Written
Much of what Giessel described was not a list of objections but a list of repairs they have been making in Senate Resources for the next bill during the special session.
The Legislature received the measure on March 20 and has held 36 hearings since. Out of them came guardrails. A cap on consumer gas prices. A bar on cost overruns reaching ratepayers. An unresolved question of who regulates the pipeline tariff, given that the project is permitted under the federal FERC rather than the state RCA. Impact funds for communities along the corridor, plus per-capita funding statewide so that every community sees a share. Expanded oversight of AGDC and approval authority over any divestiture of the state’s stake, which matters because the state has put roughly $1 billion into this effort and transferred 75 percent of it to Glenfarne. The statutory option for the state to buy 25 percent equity arrived with a six-month decision window; she is pushing for a year. A contingency provision would claw back the relief if Phase 2 never materializes.
Behind all of it sits what she called the iron law of megaprojects, the finding that most run over budget, over time, and under benefits. That is why she wants the fiscals to survive an overrun the project has not had yet.
Two fiscal questions remain genuinely open, and both move large numbers. The 45Q carbon credits, she said, may flow mostly to the developer with little to the state. And because the developer is structured as an LLC, a pass-through entity, it would owe no state corporate tax on profits.
There was one more, from Watson to Sims, that gets at what the deal actually does. Does the Phase 1 contract let utilities buy cheaper gas elsewhere if world prices fall, or does a minimum take-or-pay lock them in? There is a minimum, Sims confirmed, and the flexibility around it is still being negotiated. Certainty costs money, and that answer determines how much of it Alaska is buying.
What It Comes Down To
Strip away the mill rates and the carbon credits and the panel agreed on the destination. Alaska cannot keep heating itself on a basin that is emptying, and a fixed, capped price beats exposure to a market it cannot control. The disagreement is about how to split the bill and how fast a project of this size can be vetted in a special session with weeks left, which is not nothing, but it is a narrower gap than 47 years of false starts would suggest.
Giessel, who watched the last megaproject get built and remembers when pipeline-boom wages let the Teamsters buy an Anchorage hospital, answers to her constituents. Micciche, who ran the Kenai LNG plant for decades, answers to the 62,000 people living where this one would sit. Both want it. Both have shown where they will give. The question now is whether the rest of the terms can be settled before the clock runs out.
If you found this useful and you are not yet a member, we would be glad to have you. Join Commonwealth North at commonwealthnorth.org.
